Set up your planning poker session in seconds. Online app to support you and your team with story point estimations. Planning Poker is an agile estimating and planning technique that is consensus based. To start a poker planning session, the product owner or customer reads an agile user story or describes a feature to the estimators. Each estimator is holding a deck of Planning Poker cards with values like 0, 1.
A powerful scrum software that supports scrum project management. It features scrum tools like user story map, product backlog management, sprint backlog management, task management, daily scrum meeting, sprint planning tool, sprint review tool, sprint retrospective tool, burndown, impediment, stakeholder and team management.
The Accuracy of Group vs. Individual Estimation
According to some study on the accuracy of estimation of effort between individual and group in an experiment for a software project. 20 software professionals from the same company individually estimated the work effort required to implement the same software development project. The participants had different background and roles and the software project had previously been implemented. After that, they formed five groups. Each group agreed on one estimation by discussing and combining of the knowledge among them.
Result – The estimates based on group discussions were more accurate than the individual estimates.
What is Planning Poker?
Planning Poker Application Free Download
Planning poker (also known as Scrum poker) is a consensus-based, gamified technique for estimating, mostly used to estimate effort or relative size of development goals in software development.
Steps for Planning Poker
- To start a poker planning session, the product owner or customer reads an agile user story or describes a feature to the estimators.
For example:
“Customer logs in to the reservation system”
“Customer enters search criteria for a hotel reservation” - Team members of the group make estimates by playing numbered cards face-down to the table without revealing their estimate (Fibonacci values: 1,2,3,5,8,13,20,40)
- Cards are simultaneously displayed
- The estimates are then discussed and high and low estimates are explained
- Repeat as needed until estimates converge
By hiding the figures in this way, the group can avoid the cognitive bias of anchoring, where the first number spoken aloud sets a precedent for subsequent estimates.
Agile Estimation – Relative vs Absolute
An estimate is nothing more than a well educated guess. We use all the knowledge and experience at hand to make a guess about the amount of time it is going to take. So instead of looking at every new work item separately, why not compare it to previously finished work items? It’s easier for humans to relate to similar items than to guess the actual size of things anyway.
Planning Poker Application Free Downloads
For example, is it closer to this really small thing? Or is it more like this normal sized item? Or is it really huge like that one piece of work we finished last month? Doing relative estimates will not only reduce the amount of time spent on estimating work, it will also heavily increase the accuracy of the estimates.
Our brain is not capable of doing absolute estimates; we always put that new thing that we need to estimate in relationship to things we already know.
Fibonacci sequence and Planning Poker
Planning Poker uses of the Fibonacci sequence to assign a point value to a feature or user story. The Fibonacci sequence is a mathematical series of numbers that was introduced in the 13th century and used to explain certain formative aspects of nature, such as the branching of trees. The series is generated by adding the two previous numbers together to get the next value in the sequence: 0, 1, 1, 2, 3, 5, 8, 13, 21, and so on.
Planning Poker Application Free Templates

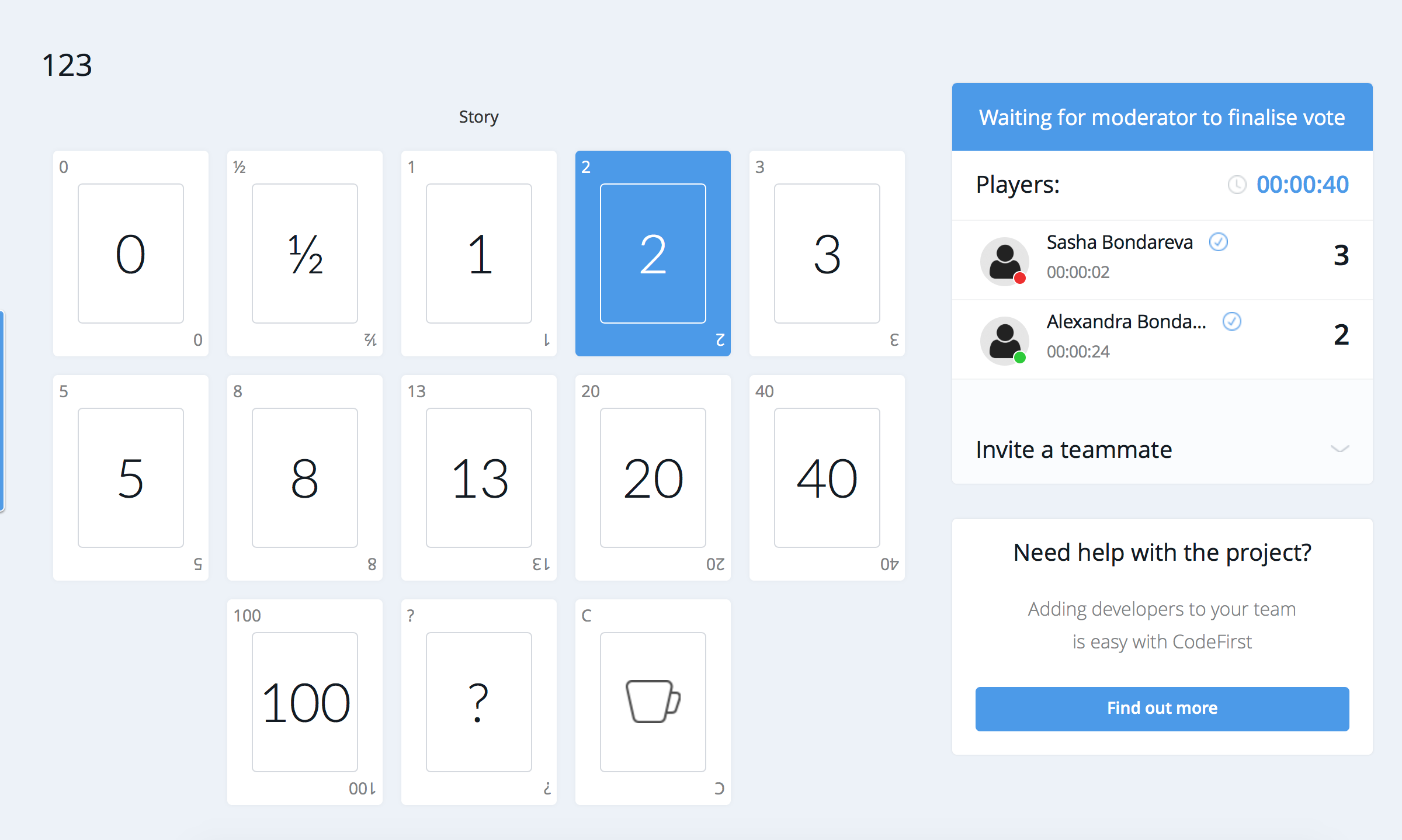

For agile estimation purposes, some of the numbers have been changed, resulting in the following series: 1, 2, 3, 5, 8, 13, 20, 40, 100 as shown in the Figure below:
The Interpretation of the point assigned to a poker card is listed in the table below:
Card(s) | Interpretation |
---|---|
0 | Task is already completed. |
1/2 | The task is tiny. |
1, 2, 3 | These are used for small tasks. |
5, 8, 13 | These are used for medium sized tasks. |
20, 40 | These are used for large tasks. |
100 | These are used for very large tasks. |
<infinity> | The task is huge. |
? | No idea how long it takes to complete this task. |
<cup of coffee> | I am hungry 🙂 |
Point vs Hour Value in Estimation
So why use story points instead of time values? Story pointing allows the team to focus on the complexity and time involved in delivering a piece of work. The team compares the new work against work they’ve already done. They compare the complexity of the new assignment against past challenges and rank the difficulty as well as the time required.
For example, we don’t often account for “the cost of doing business.” Meetings, email, code reviews, etc. with time values. But in reality, all these are necessary practices throughout in our daily life, but don’t actually count as “work.” Story points isolate the software development work from the associated logistic work items, so estimates using point based should more consistent than hour base approach.
About Visual Paradigm |
Visual Paradigm help organizations stay competitive and responsive to change faster and better in today’s fast changing environment. Our award-winning products are trusted by over 320,000 users in companies ranging from small business, consultants, to blue chip organizations, universities and government units across the globe. It enables organizations to improve business and IT agility and foster innovation through popular open standards and process frameworks.Visual Paradigm, a killer Agile feature in 2018, introduced Scrum Process Canvas for automating the way a Scrum team to create, manage and deploy software application that empowers the team to continuously improve their performance at unprecedented speed and scale. Manage the Entire Scrum Process in One Page
|
Planning Poker Application Free Online
A well-established best practice is that those who will do the work, should estimate the work, rather than having an entirely separate group estimate the work.
But when an agile team estimates product backlog items, the team doesn’t yet know who will work on each item. Teams will usually make that determination either during iteration (sprint) planning or in a more real-time manner in daily standups.
This means the whole team should take part in estimating every product backlog item. But how can someone with a skill not needed to deliver a product backlog item contribute to estimating it?
Before I can answer that, I need to briefly describe Planning Poker, which is the most common approach for estimating product backlog items. If you are already familiar with Planning Poker, you can skip the next section.
Planning Poker
Planning Poker is a consensus-based, collaborative estimating approach. It starts when a product owner or key stakeholder reads to the team an item to be estimated. Team members are then encouraged to ask questions and discuss the item so they understand the work being estimated.
Each team member is holding a set of poker-style playing cards on which are written the valid estimates to be used by the team. Any values are possible, but it is generally advisable to avoid being too precise. For example, estimating one item as 99 and another as 100 seems extremely difficult as a 1% increase in effort seems impossible to distinguish. Commonly used values are 1, 2, 3, 5, 8, 13, 20, 40, and 100 (a modified Fibonacci sequence) and 1, 2, 4, 8, 16, and 32 (a simple doubling of each prior value).
Once the team members are satisfied they understand the item to be estimated, each estimator selects a card reflecting their estimate. All of the estimators then reveal their cards at the same time. If all the cards show the same value, that becomes the team’s estimate of the work involved. If not, the estimators discuss their estimates with an emphasis on hearing from those with the highest and lowest values.
If you aren’t familiar with estimating product backlog items this way, you may want to read more about Planning Poker before continuing.
How Can Someone Participate Without the Needed Skills
Equipped with a common understanding of Planning Poker, let’s see how a team member can contribute to estimating work that they cannot possibly be involved in. As an example, consider a database engineer who is being asked to estimate a product backlog item that will include front-end JavaScript and some backend Ruby on Rails coding, and will then need to be tested.
How can this database engineer contribute to estimating this product backlog item?
There are three reasons why it’s possible--and desirable.
1. Planning Poker Isn’t Voting
When playing Planning Poker, participants are not voting on their preferred estimate. The team will not settle on the estimate that gets the most votes. Instead, each estimator is given the credibility they deserve. If one programmer wrote the original code that needs to be modified and happened to be in that same code a couple of days ago, the team should give more credence to that programmer’s estimate than to the estimate of a programmer who has never been in this part of the system.
This means that each team member can estimate, but that the team will weigh more heavily the opinions of those more closely aligned with the work.
2. Estimates Are Relative and That’s Easier
In Planning Poker, the estimates created should be relative rather than absolute estimates. That is, a team will say things like, “This item will take twice as long as the other item, but we can’t estimate the actual number of hours for either item.”
For example, this blog post contains one illustration. I provided my artist with a short description of what I had in mind for an image and he created the illustration. Most of my blog posts have one title illustration. Even though I have no artistic skill, I could estimate the work to create those illustrations as about equal each week.
Sure, some illustrations are more involved, and others can reuse a few elements from a past illustration. But most are close enough that I could estimate them as taking the same effort.
But some blog posts have two images. Even though I have no design skills at all, I’m willing to say that creating two images will take about twice as long as creating one image.
So a tester is not being asked to estimate how many hours it will take a programmer to code something. Instead the tester is estimating coding that thing relative to other things.
That can still be hard but relative estimates are easier than absolute estimates. And remember that because of point one above, the person whose skills may not be needed on the story will not be given as much credibility as someone whose skills will be used.
3. Everyone Contributes, Even If They Don’t Estimate
I want everyone on the team to participate in an estimating meeting. But that does not mean everyone estimates every item.
Despite relative estimating being easier than absolute estimating, there will still be times when someone will not be able to estimate a particular product backlog item. This might be because the person’s skills aren’t needed on that item. But that person may still be able to contribute to the discussion.
Sometimes the person whose skills are not needed on a given product backlog item will be the most astute in asking questions about the item, uncovering overlooked assumptions, or in seeing work that others on the team have missed.
For example, a database developer whose skills are not needed to deliver a product backlog item may be the one who remembers that:
The team promised to clean up that code the next time they were in it
There is an impact on reports that no one has considered
That when the team did a similar story a year ago it took much longer than anyone anticipated
and so on. The database developer may know these things or ask these questions even if unable to personally estimate their impact on the work.
A Few Examples
To provide a few examples, let’s return to role of a database engineer in estimating a product backlog item that has no database work. Here are some examples of things that team member might say that would add value to estimating that product backlog item:
- “I’m holding up this high estimate because this sounded like a lot of effort to code. It sounded like about twice as much as this other backlog item.”
In this case, the database engineer is making a relative assessment of effort. This will presumably be based on things said by coders. In some cases, the database engineer may be wrong in that assessment. But that doesn’t mean the person’s opinion is always without merit. The database engineer’s opinion should be given the merit it deserves (which may be great or little). - “Are you sure it’s that much work? I thought two sprints ago, you programmers were going to refactor that part of the system. If that happened, isn’t this easier now?”
Here the database engineer is bringing up information that others may not have recalled or considered. It may or may not be of value. But sometimes it will be. - “Are you sure it’s not more work than that? Have you considered the need to do this and that?”
In this case, the database engineer is pointing out work that the others may have overlooked. If that work is significant, it should be reflected in the estimate.
When Everyone Participates, It Increases Buy In
There’s one final reason why I suggest the whole team participate when estimating product backlog items, especially with a technique such as Planning Poker: Doing so increases the buy in felt by all team members to the estimates.
When someone else estimates something for you or me, we don’t feel invested in that estimate. It may or may not be a good estimate. But if it’s not, that’s not our fault. We will do much more to meet an estimate we gave than one handed to us.
We want everyone on a team to participate in estimating that team’s work. You never know in advance who will ask the insightful questions about a product backlog item. Sometimes it’s one of the team members who will work on that item. But other times those questions come from someone whose skills are not needed on that item.
So while not every team member needs to provide an estimate for each item, every team member does need to participate in the discussion surrounding every estimate. Teams do best when the whole team works together for the good of the product, from estimation through to delivery.
What Has Your Experience Been?
What has your experience been with involving the whole team in estimating product backlog items? Have you found it beneficial to have everyone participate even though not everyone has skills needed on each item?
